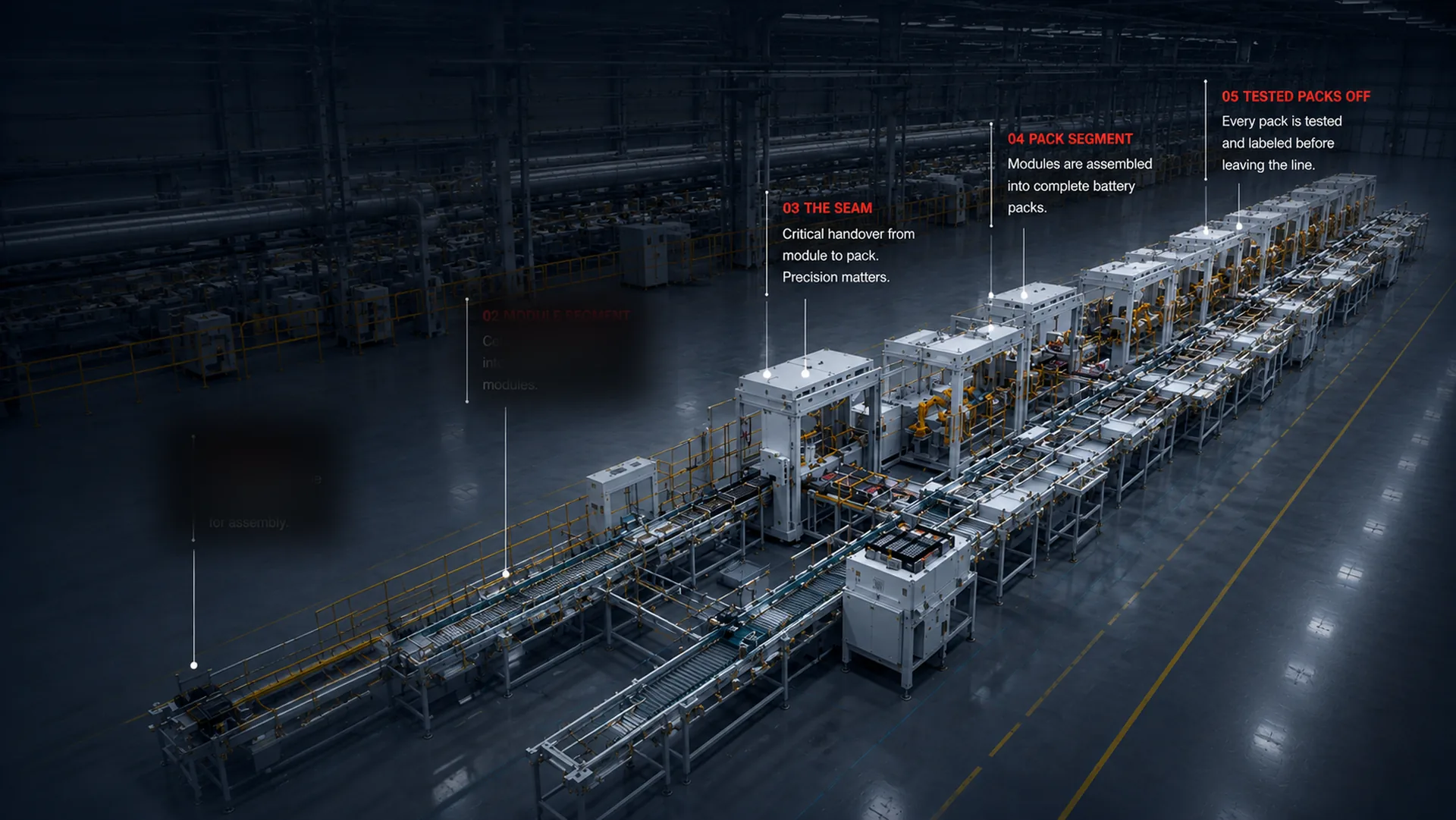

Cells in at one end, tested packs off the other — one takt across both segments +86 15327155363 [email protected]

Module & pack assembly lines / 4–15 PPM

Battery Module & Pack Assembly Lines, Built to the Cell You Already Bought

Cells in at one end, tested packs off the other. Every station is labelled AUTO, SEMI-AUTO or MANUAL, so the headcount is costed before you sign.

  • 4–15 PPMLine takt across the three tiers
  • 500 MWh – 2 GWhAnnual output range, 314 Ah blueprint
  • 1Automated station in the pack segment — the adhesive station
  • ≥99%Line acceptance yield, equipment-caused only

The Module & Pack Line

End-to-end production architecture

8 Process Stations Module → Pack

MODULE ASSEMBLY PACK ASSEMBLY THE SEAM Module handover MODULE → PACK Module complete — owned by whoever owns the whole line. 1Cell De-trayLoadingAUTO · ST 012Stacking Pressing& BandingSEMI-AUTO · ST 043Busbar LaserWeldingAUTO · ST 064Module EOLTestingAUTO · ST 085ModuleInsertionMANUAL · ST 046Series BusbarInstallationMANUAL · ST 067Pack EOLTestMANUAL · ST 148PackOffloadMANUAL · ST 15

What We Hand Over — Two Segments, One Takt, One Owner

We take over once cells are inside your gate, and let go when tested packs come off the far end.

Between those two points sit a module segment and a pack segment. They are usually bought as two orders, from two suppliers, against two drawings. Here they are one line with one takt figure and one acceptance document, which is the whole reason this page exists.

Two segments, one takt

Loose cells become tested modules, then closed, tested packs — commissioned to one figure, not two.

One handover point

Where the two segments meet is where lines stop rather than slow. Section 07 is about that position.

Scope in one line

Cell manufacturing upstream of your gate is a different plant with different equipment, and none of it is ours.

What a quote covers

Layout design, equipment, installation, commissioning, acceptance and operator training.

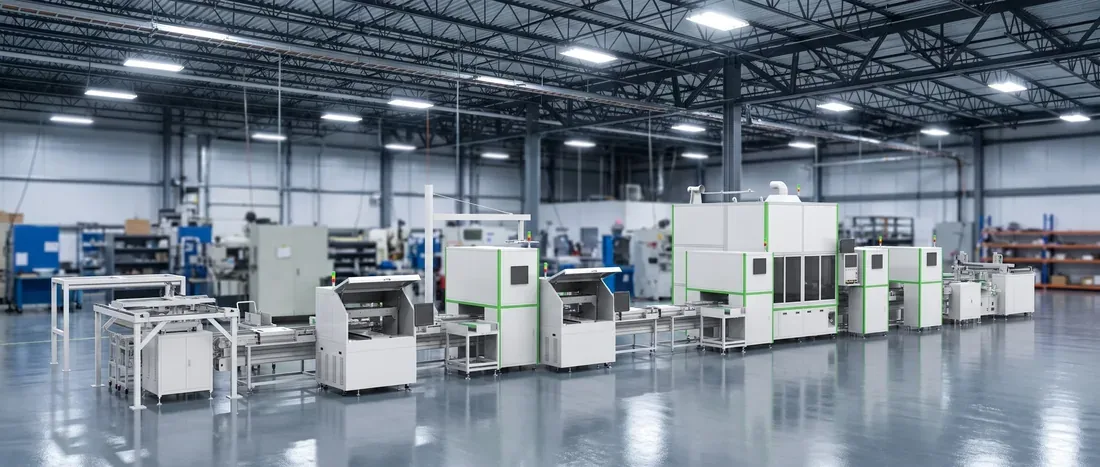

Middle of a module assembly line, gantry and enclosed process cell
Module segment — stack, press, weld

Prismatic lithium cells arriving at the line, ready for unloading and sorting
Cells in — prismatic, contracted

Assembled battery module with busbars fitted, leaving the module segment
Module out — into the pack segment

Three Lines, Separated by the Two Numbers That Decide the Tier

Takt and annual output are enough to tell you which tier you are shopping in. Everything else is a conversation.

BLP-P8S4–8 PPM
Semi-automatic, economy tier.
500 MWh – 1 GWh annual output.
Learn more

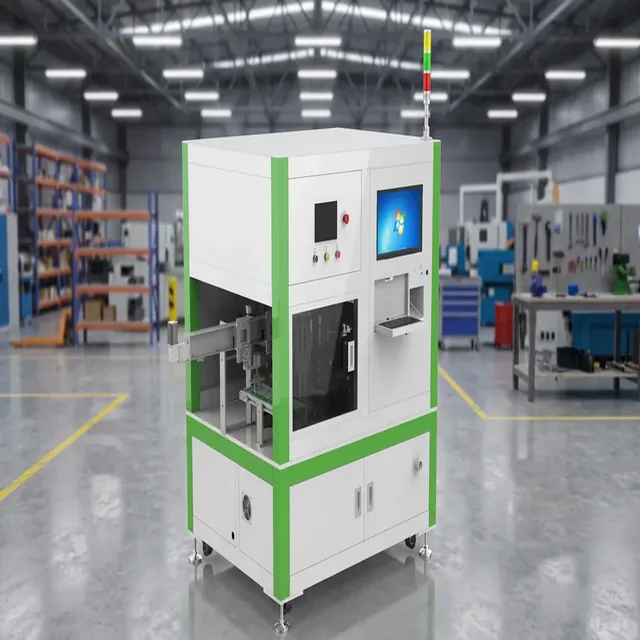

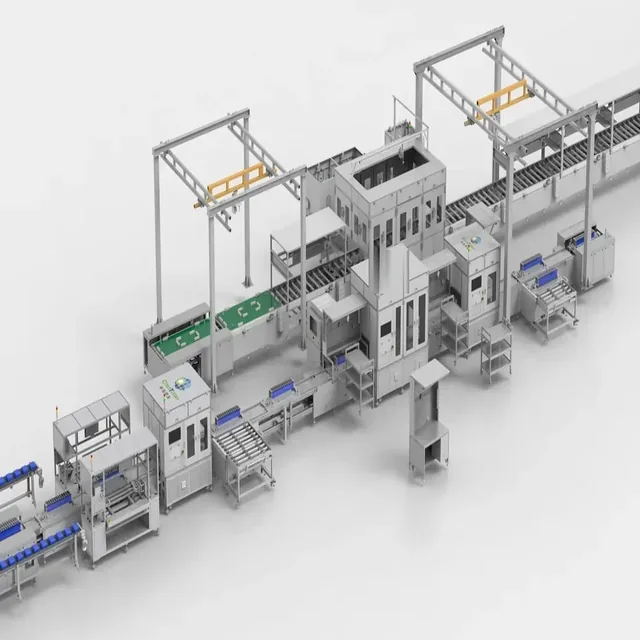

BLP-P8S module and pack assembly line, 4–8 PPM tier
BLP-P88 PPM
Standard configuration.
Annual output on request.
Learn more

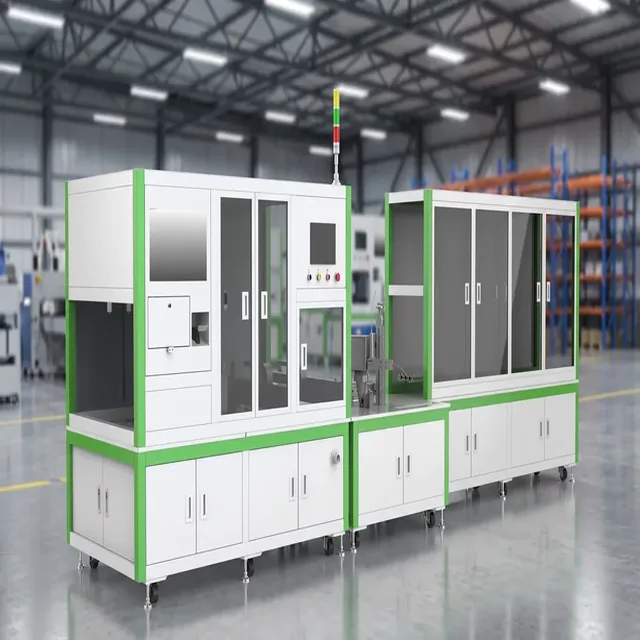

BLP-P8 module and pack assembly line, 8 PPM tier
BLP-P1512–15 PPM
High automation.
1 – 2 GWh annual output.
Learn more
BLP-P15 module and pack assembly line, 12–15 PPM tier
01

The basis

Annual output assumes the 314 Ah blueprint cell, 300 days a year, eight hours a day.
02

Why two of them overlap

Footprint, installed power and automation level separate P8S from P8 — takt alone does not.
03

On request means on request

The P8 output figure is published once the line is engineered, not estimated to fill a table cell.

Full comparison — footprint, installed power, headcount and automation level — on the tier-selection page.

Three Kinds of Buyer, and One We Cannot Help

Two minutes here saves a fortnight of quotations that were never going to fit your project.

Storage integrator, order signed

You have the cell, a pack design and an output already promised. What you need is the back end of a plant, inside a building you occupy.

Cell maker's pack shop

The front of your plant exists. The module and pack segments are the gap, and the question is whether they join what already runs, at one takt.

New plant abroad

Nothing is fixed on the floor yet, so the layout can still be drawn around the line rather than the other way round. The cheapest moment to talk.

Not us: cell production

Mixing, coating, calendering, winding, formation. A different plant with different equipment. No part of it is ours, and we say so in the first reply.

Three of those four start in the same place: something has already been signed. The fourth is worth naming because a fast no is cheaper for you than a polite maybe — a supplier who takes the meeting anyway costs you a fortnight you will not get back.

Three Things Are Fixed Before Anyone Quotes You a Line

Almost every project that reaches us is standing in the same place, with the same three decisions already behind it.

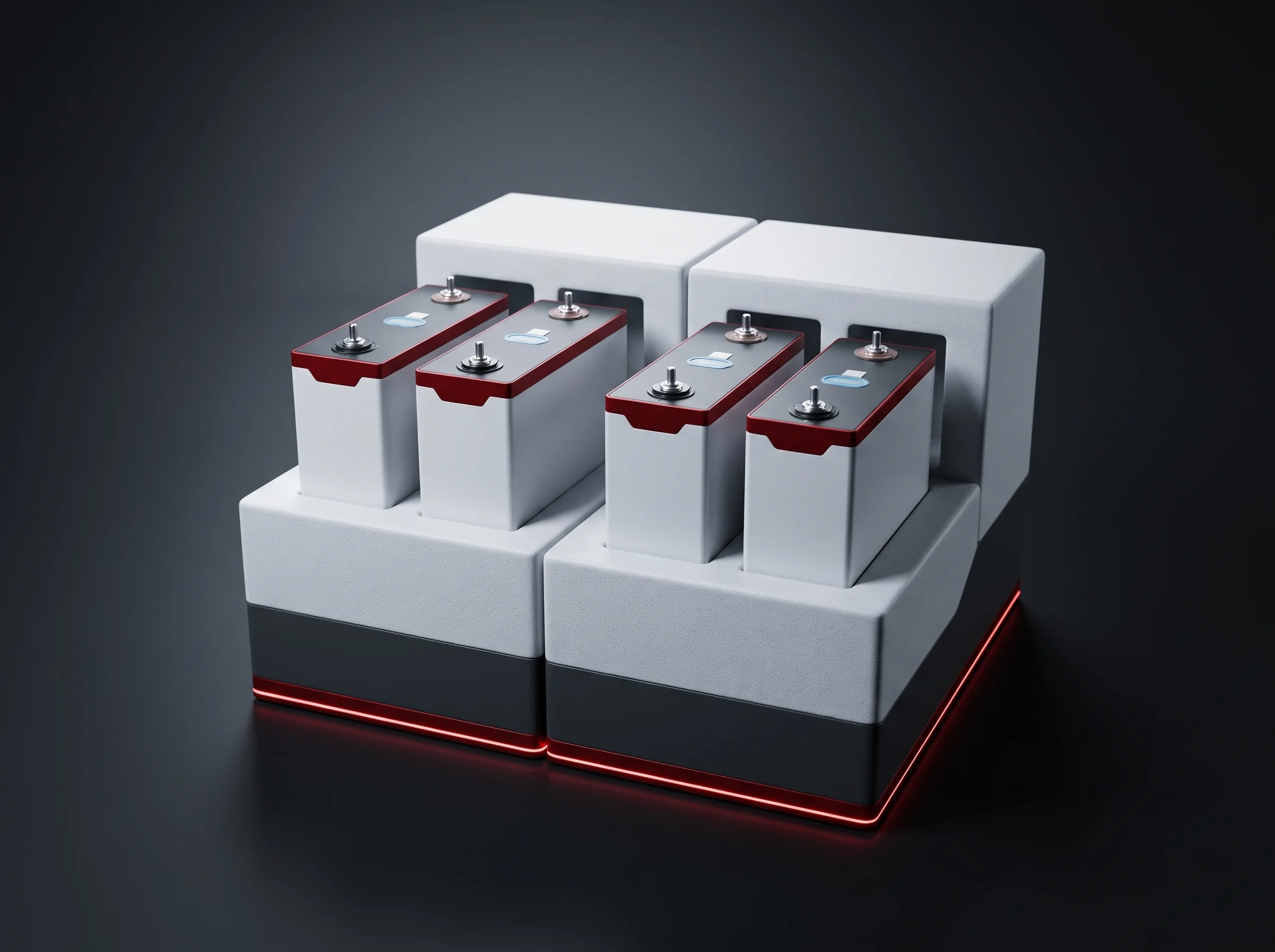

Prismatic cells delivered on protective foam trays before entering the line
Contracted before the equipment budget
  • The cell
  • The output
  • The building

The cell is fixed

Prismatic, 280 or 314 Ah, contracted long before the equipment budget existed.

The output is fixed

It was promised to somebody upstream, and it is not going to be renegotiated to suit a line.

The building is fixed

Length, width and clear height were set years ago by somebody who was not thinking about takt.

The middle is the only part still open, and it is the part this site is about. Everything around it already carries someone else's signature — so a line that asks you to change the cell, the output or the building is not a line you can buy.

Three Ways a Module-and-Pack Project Goes Sideways

Each one is opened up on the page that owns it. Here they are only worth naming, with the page to read next.

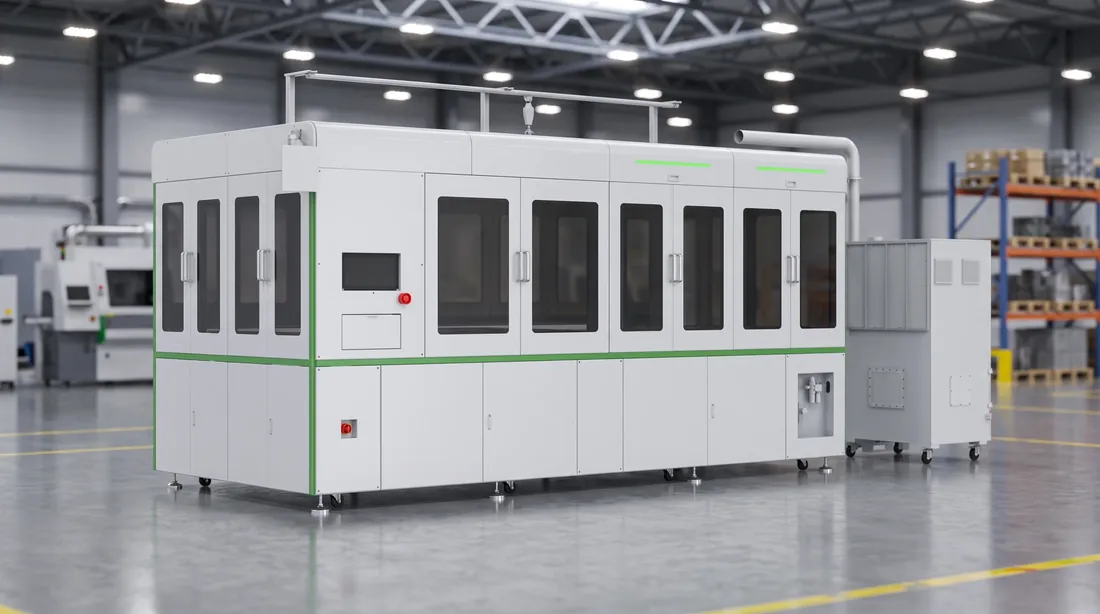

Large multi-door process enclosure of a high-automation assembly line

Sized against your peak

The busiest month on the forecast becomes the takt, and a 15 PPM line then runs for years at a fraction of it. You paid for automation you do not use.
Tier selection
Transfer station between two machines standing empty on an assembly bench

Two suppliers, one seam

Splitting the order across a module supplier and a pack supplier splits ownership of the point where the two meet. Both can deliver what they quoted while the pair does not run.
Section 07

End-of-line electrical test station with the enclosure open

Nothing to accept against

Adjectives cannot be measured on handover day. If takt, yield and station-level automation are not written down before the order, acceptance becomes an argument.
EOL testing

None of the three shows up on a layout drawing. All three show up in the second week of ramp-up, when the takt is real and the workarounds start. The cheapest place to deal with any of them is on paper, before anything has been cut.

A line rarely fails at the station you were worried about. It fails at the seam between two things that were each correct on their own drawing.

Module segment

Correct on its own drawing.

Pack segment

Also correct on its own drawing.

The seam between them

Nobody's job by default — which is why it is section 07.

The Seam Between the Two Segments, and Who Owns It

Of everything that can go wrong on a line, this is the one that belongs to whoever owns the whole line.

The handover position — one carrier on one side, receiving tooling on the other

Transfer mechanism handing a finished module from the module segment into the pack segment
01 · Why this one

Every other failure here has a page that owns it. This one has none.

Each of the three failure modes above has a station attached to it, and a page that owns that station. The seam has neither. It is the single position where two sets of drawings, two sets of tooling and two assumptions about takt all have to agree at once — and the only one of them that is nobody's job by default.

02 · Without it

Three things have to line up at one position

The carrier a finished module travels on. The tooling that receives it on the pack side. The takt both sides are commissioned to. Each supplier can be entirely correct on their own drawing while the two disagree by a few millimetres or a few seconds.

03 · What it costs

A line does not slow at that point. It stops.

The stations upstream keep running, so work piles up behind the handover while the pack side stands empty. The correction is tooling re-cut and both sides re-timed — on your floor, during ramp-up, against an order that was promised before the equipment arrived.

04 · What we do

One line, one takt, one owner across both segments

The carrier and the receiving tooling are drawn against your module drawing before anything is cut. Both segments are then commissioned to the same takt figure using your parts, not samples, so the handover is proven with what you will actually run.

05 · What proves it

One published takt figure for both segments, not two that happen to be close

4–8, 8 or 12–15 PPM, stated once and applied across the whole line. A format change lands on this seam before it lands anywhere else, which is why the tooling on both sides of it is drawn, quoted and accepted as one job rather than two.

Vision locating station checking module position and polarity before the handover
Locating before the handover

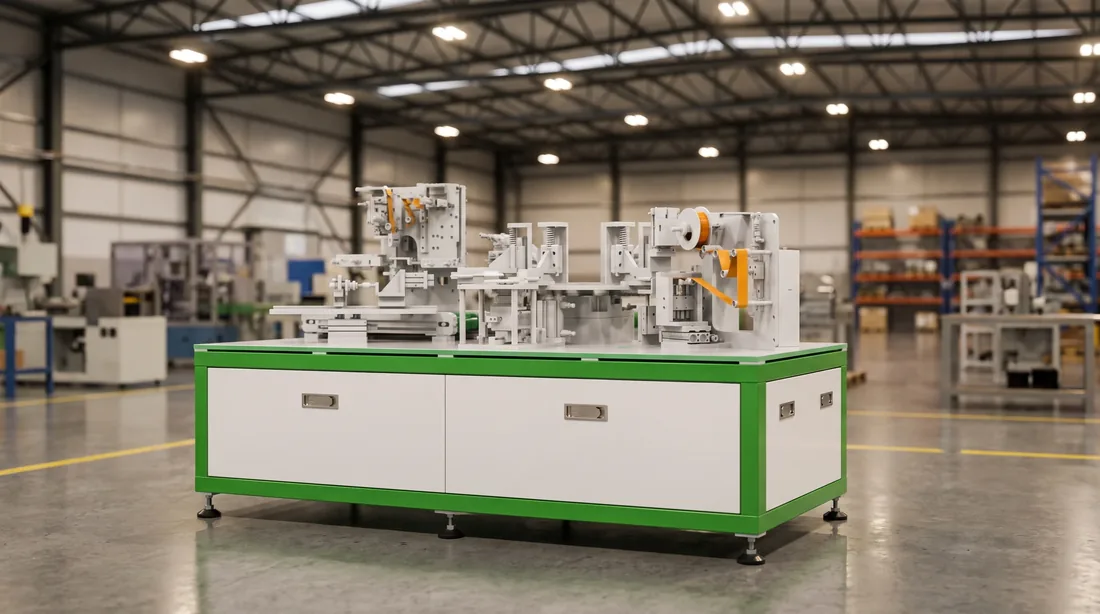

Receiving tooling and fixtures on the pack side of the handover
Receiving tooling, cut to your parts

AUTO, SEMI-AUTO, MANUAL — the Label That Sets Your Headcount

It is the one line on a quotation you can check yourself, and the one most quotations leave out.

  • Auto
  • Semi-auto
  • Manual

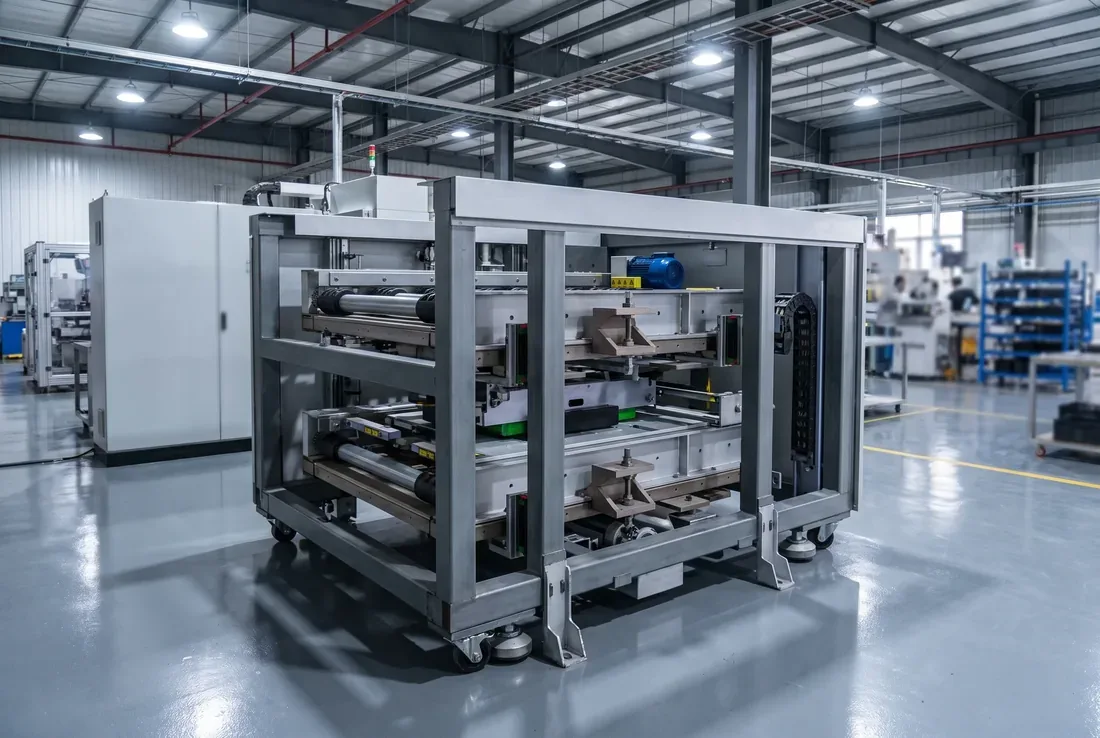

AUTOAutomated transfer and clamping mechanism inside a machine frame

AUTO — the station runs itself

In a standard pack segment exactly one station is automated: the adhesive station. Any supplier describing a pack segment as end-to-end automatic is describing a brochure.

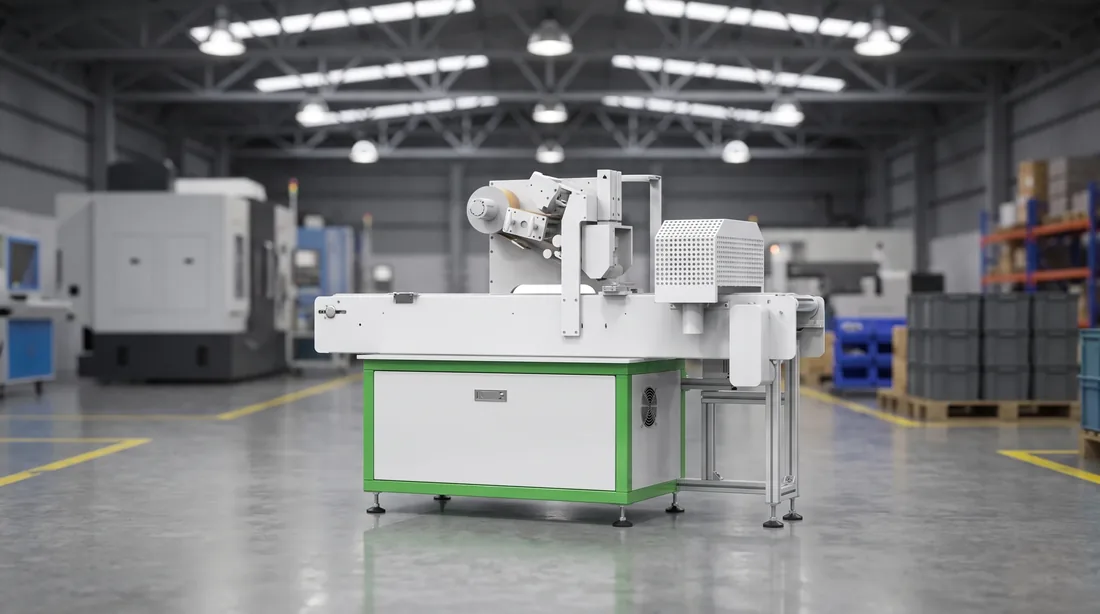

SEMI-AUTOGantry mechanism above a work surface where parts are loaded by hand

SEMI-AUTO — the machine works, a person feeds it

The cycle belongs to the machine; the loading does not. This is where much of the module segment sits, and where headcount is easiest to underestimate.
MANUALOpen bench station where an operator performs the work by hand

MANUAL — a person does the work

Most of the pack segment: 12 to 14 operators on the P8S and P15 pack sections. Written down, that can be budgeted for ten years. Left out, it arrives as a surprise.

The same three labels appear in three places and have to agree in all of them: on the layout drawing, in the station list, and in the acceptance document you sign. A quotation that carries them everywhere is one you can compare; one that carries them nowhere is one you cannot.

Your Cell Decides Every Fixture Downstream of It

Which is why the first question we ask is about the cell, not about the output you are targeting.

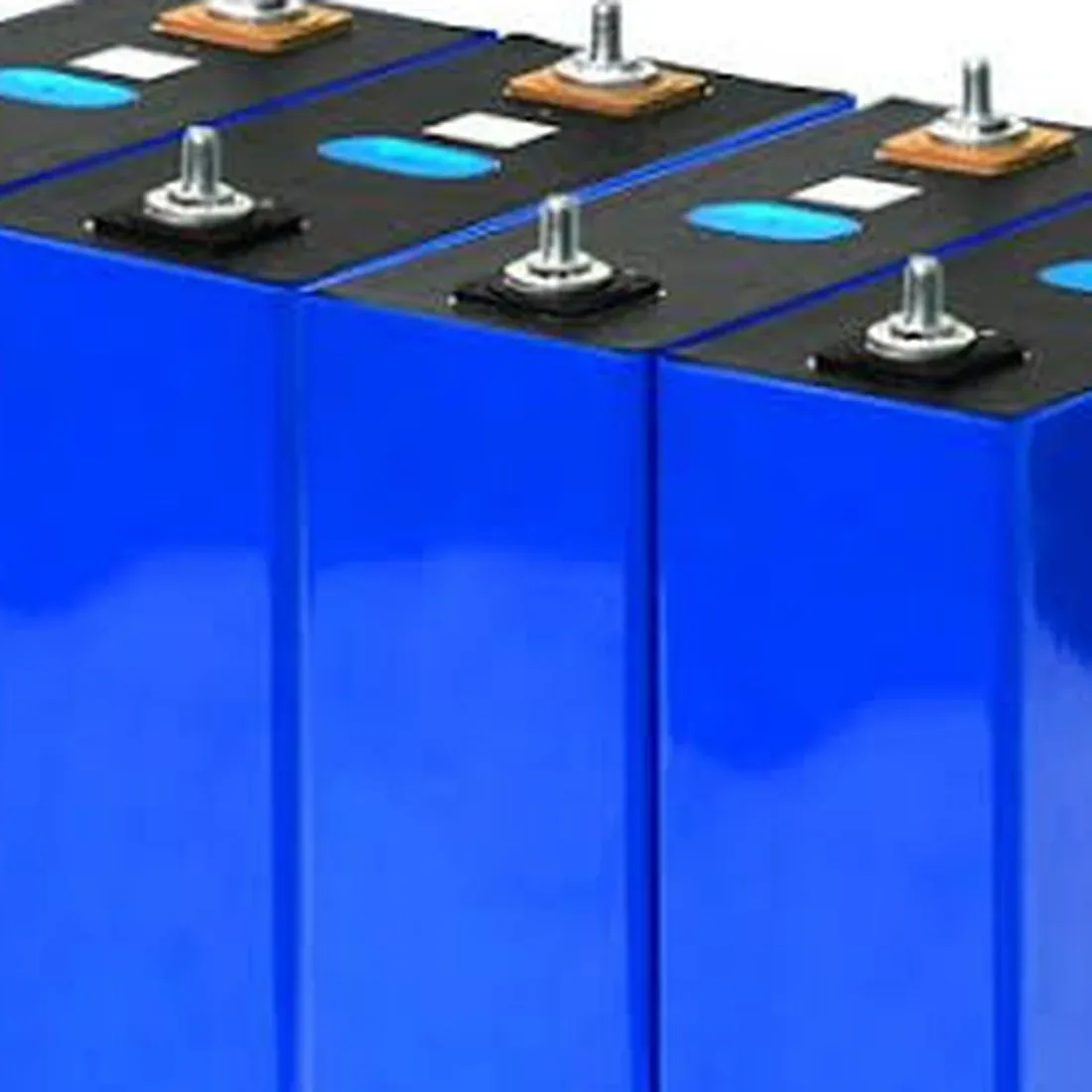

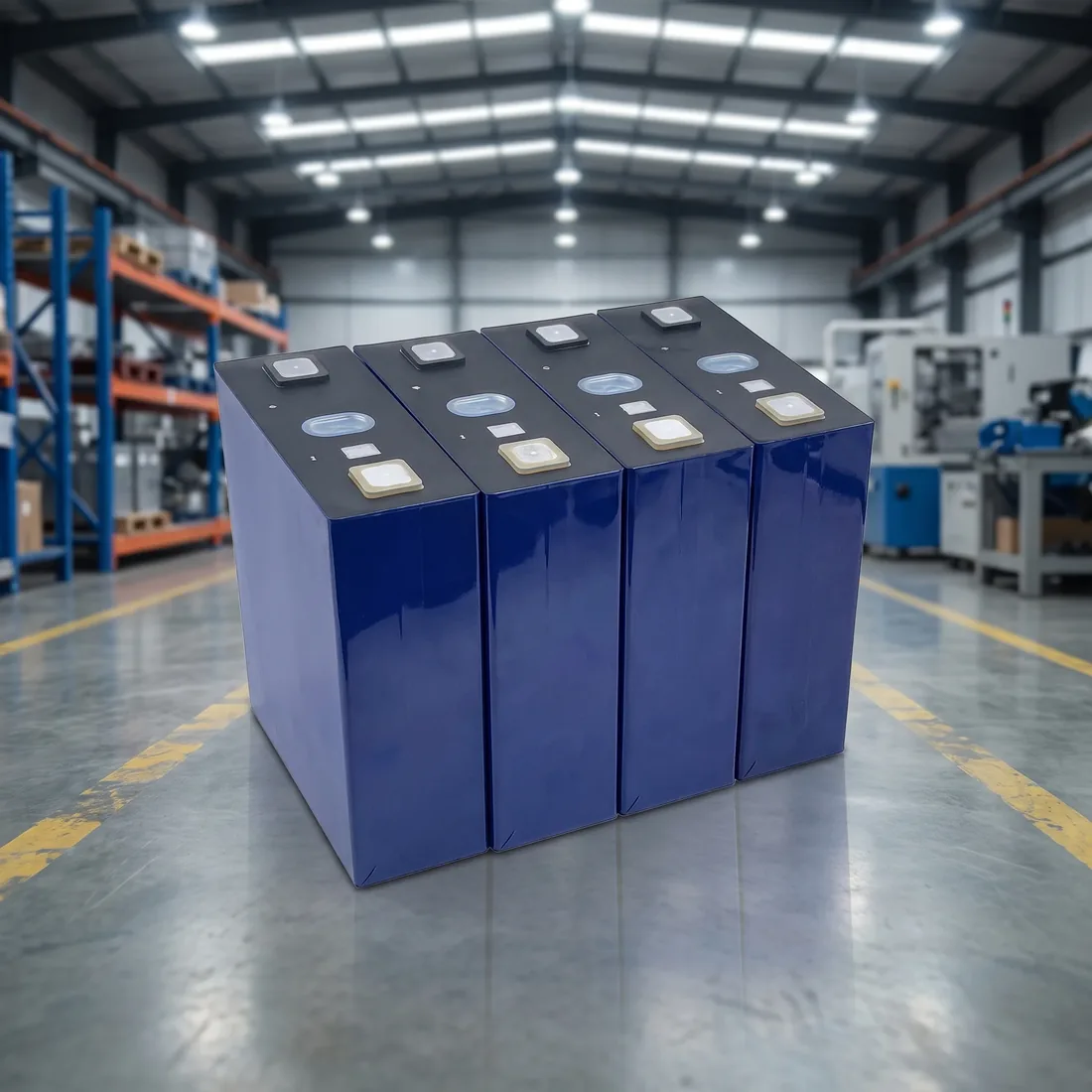

Terminals and top plate of prismatic cells, close view
Terminal position sets the welding path
  • Fixtures
  • Grippers
  • Locating faces

A prismatic cell fixes how cells are presented to the line, the stacking pitch, the pressing envelope and where the terminals sit. Every station that touches a cell or a module is dimensioned from those four facts. Change the format and the fixtures change with it — the sequence of stations does not.

One blueprint: 314 Ah

The 280 Ah prismatic is the other format we see most often.

A stated blueprint is what makes quotes comparable

Without one, two prices describe two different lines and neither of them is yours.

Changeover has a price

What a format change costs in tooling and downtime is set out on the compatibility page, not estimated here.

Every Position Is Quoted With the Figure It Is Judged On

The one claim on this page you can test in a minute, using the quotations already sitting on your desk.

Enclosed laser welding station with control screens along the front
Welding speed, weld depth, pull-off strength

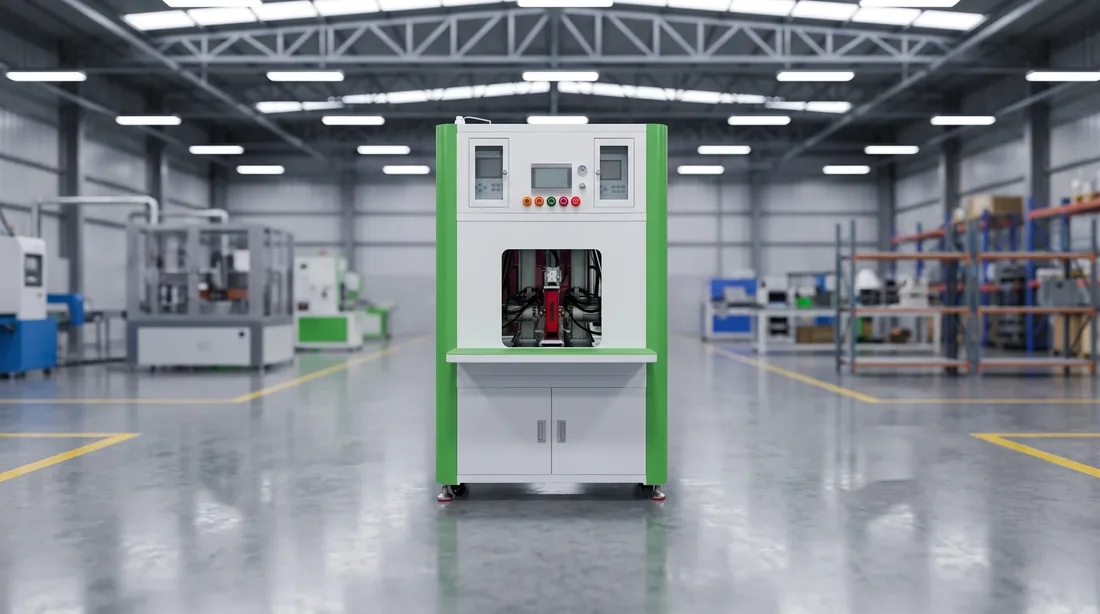

Electrical test station with the measurement fixture visible
Voltage and resistance accuracy
  • Pressing force
  • Welding speed
  • Positioning accuracy

Pressing force, welding speed, positioning accuracy, pull-off strength — each one is published on the page that owns that position, rather than compressed into an adjective. Pick any position on the line, follow it through to its page, and there is a figure waiting for you.

Checkable in a minute

Follow any station to its page and read the number off it. That is the whole test.

Two reviews, one document

Engineering needs the accuracy. Finance needs what that accuracy costs to run for ten years.

No figure, no comparison

A quotation without them cannot be compared with anything — including ours.

≥99% Acceptance Yield, Counting Equipment-Caused Defects Only

A figure we are willing to have written into the acceptance document, rather than one that lives in a brochure.

≥99% Line acceptance yield
Equipment-caused defects only

Equipment only

Incoming cell defects and bench work are excluded — in both directions.

Whole line

Both segments and the handover between them, measured as one line rather than machine by machine.

In the contract

Written into the acceptance document and measured the same way by both sides.

Yield is defined here rather than asserted. Line utilisation is time utilisation multiplied by performance utilisation multiplied by first-pass yield, and first-pass yield is units in, minus rejects, over units in. Two parties measuring that the same way is the difference between an acceptance meeting and an acceptance argument.

Your Bay Is an Input to the Layout, Not an Obstacle

The layout is drawn to the building you already have. The building does not get rebuilt to suit a standard line.

  • Length
  • Width
  • Clear height

Those three dimensions decide whether a line runs in one straight pass or folds back on itself. Folding is not a defect — it costs transfers, floor area and operator positions, and all three are cheaper to settle on a drawing than after steel is standing on your floor.

The bay has to carry the line

Floor loading, power, compressed air and nitrogen have to be there before commissioning, not after.

Utilities are what hold up a date

They are discovered late more often than any station is, and they are nobody's favourite conversation.

The figures live on one page

Bay dimensions and what each tier draws are written up separately, with values.

Storage and EV Packs Run the Same Two Segments

The sequence does not change between them. The tooling and the compatibility envelope do — and that is what decides whether a line fits.

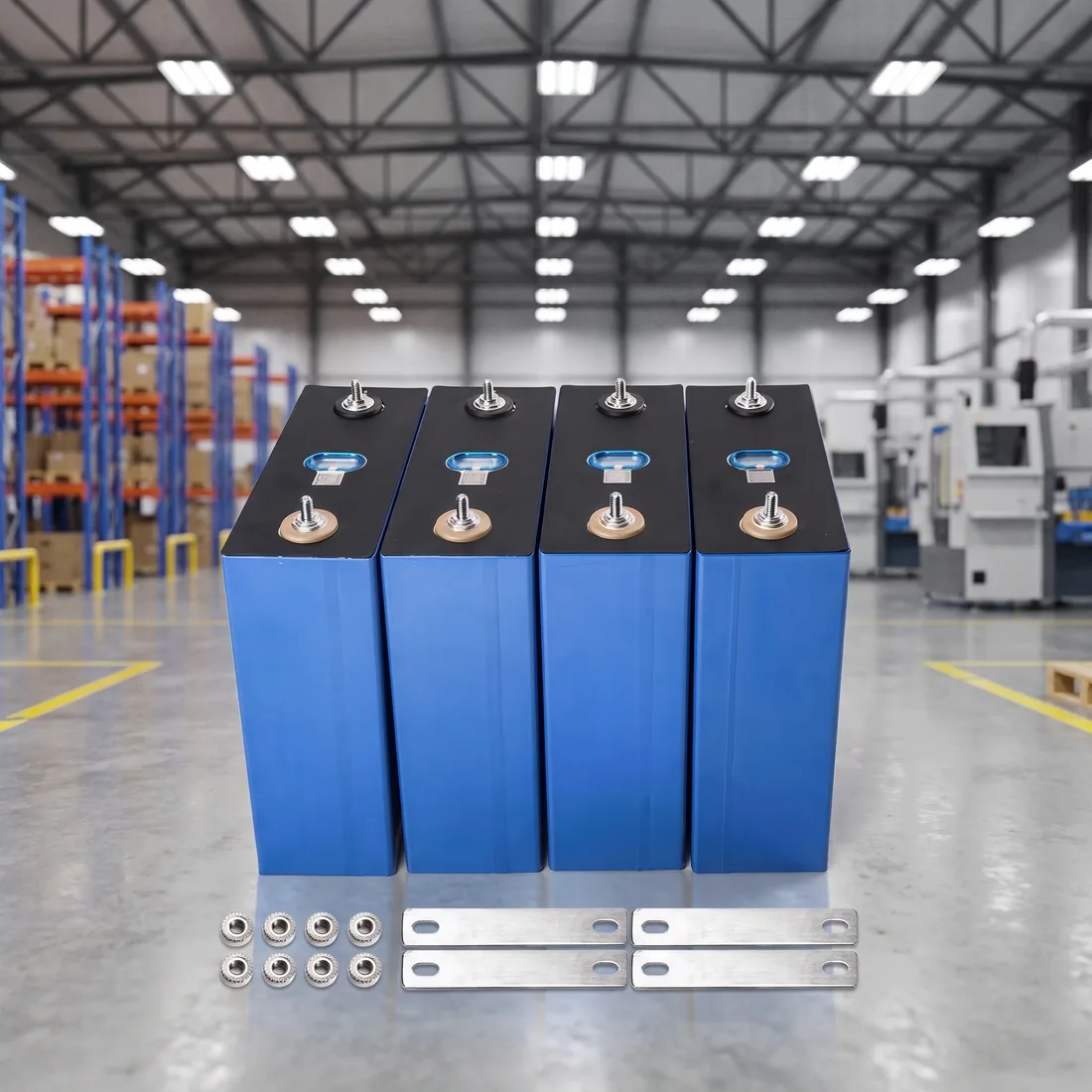

Prismatic storage cells with busbars and terminal hardware laid out for assembly

Storage pack

Commercial and industrial systems first, then grid-scale, then residential. The blueprint here is a 1P52S pack built from 314 Ah prismatic cells.
Pack enclosure with modules installed, cooling plate and harness routing visible

EV module or pack

Same station sequence, different envelope: module length, width, height and mass move, and every fixture that touches them moves with those.

A line quoted for one is not automatically right for the other, even when the two station lists read identically. What makes a line fit is the tooling behind those station names and the compatibility envelope it was drawn to, and both come from the pack you are actually building.

01

Same sequence, both

Cells into modules, modules into packs, tested and offloaded.
02

The envelope is what changes

Dimensions, mass and fixtures decide which tooling sits on the line.
03

Station lists mislead

Two identical lists can describe two lines, only one of which fits your pack.

Get a Layout Drawn to Your Bay

Cell format, target PPM, bay dimensions with clear height. Three lines of an email is enough to start.

Reply within 24 hours / No obligation / If it is not our segment, we say so first

Cell format

Prismatic type and capacity.

Target PPM

The takt the output was promised against.

Bay dimensions

Length, width and clear height.

How a Whole-Line Supplier Compares With the Two Other Ways to Buy a Pack Line

Roles, not companies. Which one fits depends on what you already own, not on which of them happens to be quoting you.

Criteria Whole-line supplierWhat this page describes Single-machine vendor Systems integrator
Who owns the seamOne owner across both segmentsNobody — it falls between ordersIntegrator, if it is in scope
Takt commitmentOne takt figure for the whole linePer machine, not per linePer line, usually
Station-level automationPublished per station, AUTO / MANUALPer machine onlyVaries by contract
Tooling to your partsCut to your enclosure, plate and module drawingsStandard tooling; your parts are your problemUsually yes, at integrator margin
Headcount you can budgetStated per segmentNot statedSometimes stated
Layout to your bayAdjusted to the building you haveNot in scopeYes
AcceptanceOne acceptance for the lineOne per machineOne for the line
Who you call when takt is missedOne numberEach vendor points at the nextIntegrator

Not every project starts with an empty bay. If a module segment already runs well, the real question is whether a pack segment can join it at one takt. If a single position is the constraint, that is a machine purchase — and a whole-line quotation for it sells you stations you did not need.

Roles, not companies — a single-machine vendor is not supposed to carry line takt. That is a different division of work, not a defect.

From Your Email to a Layout, in Five Steps

What happens next, in order, so that the first exchange holds no surprises for either side.

  1. 01

    You send three things

    Cell spec, target PPM, and bay dimensions with clear height.
  2. 02

    We come back with a layout

    The line drawn into your bay, both segments, with the seam shown.
  3. 03

    Station list and levels

    Every station named and marked AUTO, SEMI-AUTO or MANUAL, with headcount per segment.
  4. 04

    Tooling drawn to your parts

    Insertion and receiving tooling dimensioned on your enclosure, plate and module drawings.
  5. 05

    Acceptance you sign

    Yield and takt figures written into the acceptance document.
Blueprint-style layout drawing of a module and pack assembly line with the flow path highlightedg
Step 04 works from drawings like this

Two things are worth saying before step one. Drawings change the answer — if enclosure, cooling plate or module drawings already exist, send them and the layout comes back dimensioned rather than indicative. And there is no price at step one: a price quoted before a layout is a number that will change.

Nothing on this site is stated twice

Each figure above is one click from the page that owns it.

The three lines

Bay — length, width and clear height

Clear height under the lowest obstruction over the line’s run, not to the roof. Section 05 is about where that number comes from.

How to reach you

[email protected]

Sending delivers the three lines straight to our sales inbox and keeps a copy on screen. If the direct send ever fails, your email client opens with the same message — nothing is lost either way.

Phone / WhatsApp
Address
Wuhan, Hubei, China
Response
Reply within 24 hours
